Xcel Energy Meter Pull and Panel Upgrade: Twin Cities Guide

Northern Mister Sparky
Locally owned Twin Cities electrician · · 12 min read
Xcel Energy Meter Pull and Panel Upgrade: Twin Cities Guide

Key Takeaways

  • Your electrician - not you - contacts Xcel to schedule the meter pull, via the online portal or by email to Xcel’s building and remodeling team.
  • Xcel typically needs 1-3 weeks of lead time for a Twin Cities service upgrade; the full window from application to job day can run 2-12 weeks.
  • Power is off for 4-8 hours on a standard 200-amp swap; plan for 6-10 hours on a 320A or 400A service.
  • Xcel will not reinstall your meter until an approved inspection certificate is received. That certificate is the gate - not the completed work itself.
  • Saint Paul moved all electrical permit applications to the PAULIE platform as of September 9, 2026. Contractors who are not yet registered will slow down your permit.
  • Minneapolis handles electrical inspections independently; most Twin Cities suburbs use DLI inspectors.
  • The Xcel $1,500 rebate is real and worth claiming, but allow 6-8 weeks for the payment to arrive after you submit.
  • All permits filed on or after August 17, 2026 fall under the 2026 NEC, not the 2023 edition.

panel upgrade cost twin cities

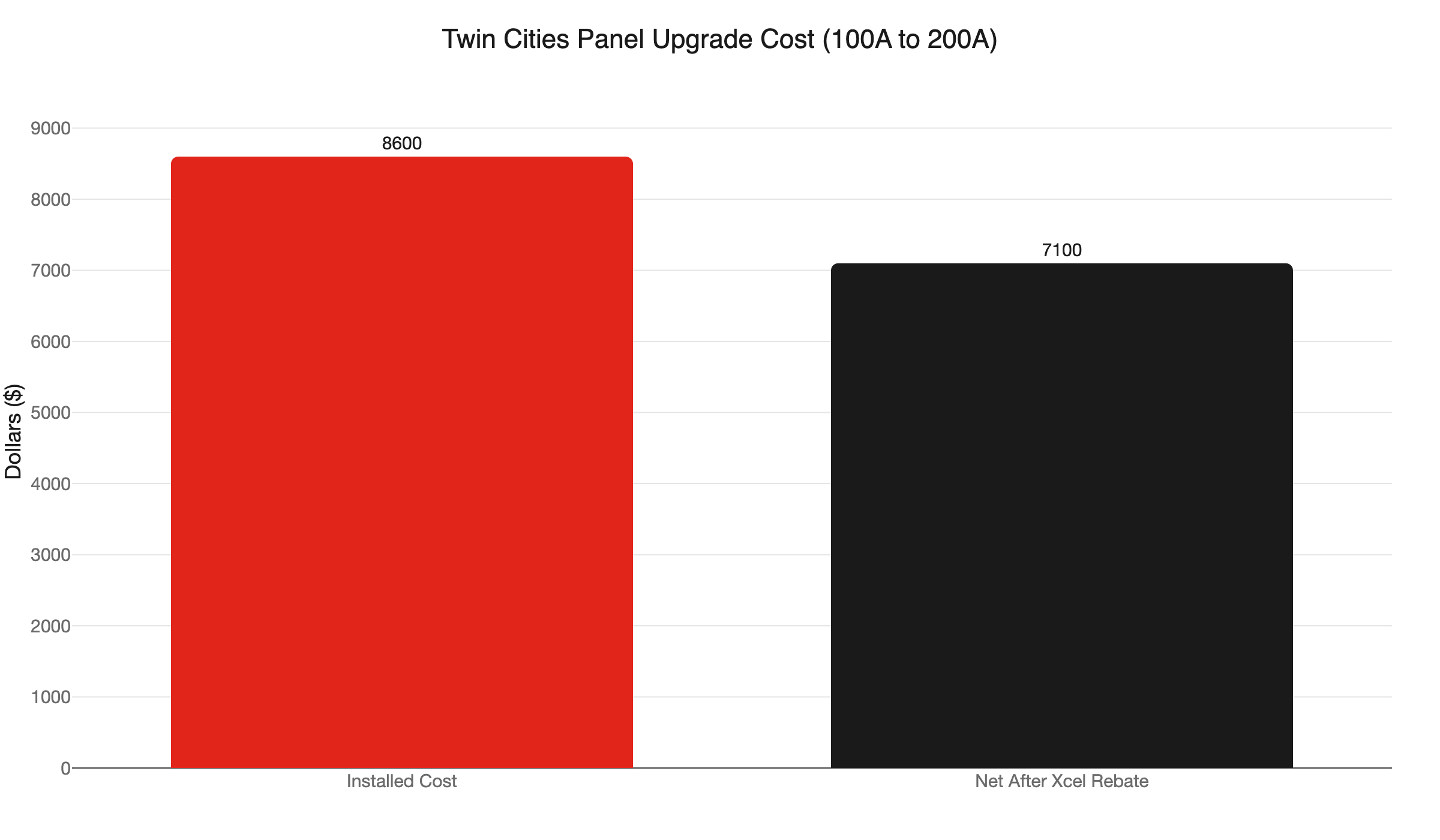

Twin Cities Panel Upgrade Cost (100A to 200A)

What Is a Meter Pull and Why Does Your Panel Upgrade Need One?

A meter pull is Xcel Energy physically removing your utility meter so the panel work can happen safely with no live voltage at the service entrance. Your electrical panel connects directly to the service entrance, which carries live utility voltage even when your main breaker is off. Xcel must de-energize that connection before any work begins. There is no way around this step for a panel upgrade.

The pull happens at the start of the job window. After the work is complete, the meter goes back in only after Xcel receives an approved inspection certificate confirming the new panel and service entrance meet code. Every other milestone on your day’s timeline - crew arrival, installation, inspection, reconnect - flows from those two anchor points.

Why Does Your Contractor Handle the Xcel Request, Not You?

Your licensed electrician submits the disconnect and reconnect request because Xcel requires a contractor of record on the service order. The electrician is responsible for the permitted scope, the condition of the meter socket, and delivering the inspection result that triggers reconnect. Homeowners cannot initiate this request on Xcel’s portal or by email.

This matters practically in two ways. First, the Xcel service request should go in before the job date is locked, not the week of. Second, errors or missing information on the request can push the scheduled pull date out by days. A contractor who has done this process many times knows what Xcel is looking for on the application and does not leave anything blank. Our team handles Xcel coordination on every panel job we do. You do not need to make a separate call to the utility.

What Happens Before the Truck Arrives: Permits and the Xcel Request

Two parallel tracks have to be in motion well before the job day: the building permit and the Xcel service request. Both require lead time, and neither can be skipped.

The permit. Every panel upgrade in Minnesota requires a permit. The electrical permit process in Minnesota varies by jurisdiction, but the core sequence is the same: your electrician submits the application, the Authority Having Jurisdiction (AHJ) reviews and issues the permit, the work proceeds, an inspector approves, and the final inspection record goes to Xcel. Which AHJ you fall under depends on your address - Minneapolis, Saint Paul, and the suburbs each have different systems (covered in detail below).

The Xcel service request. Your electrician submits a disconnect and reconnect request via Xcel’s online portal at my.xcelenergy.com/BuildingRemodeling (Create New Request, then Change Existing Service) or by email to bclco@xcelenergy.com. The request identifies the service address, the scope of work, the expected amperage change, and the anticipated job date. This is not a homeowner action - the licensed contractor initiates it.

Xcel reviews the request and assigns a scheduled date for the meter pull. If the request is incomplete, Xcel will ask for additional information before confirming the date, which adds time. The takeaway: do not sign a contract expecting next-week service if the Xcel request has not been submitted. The permit and the Xcel request need to be moving together, not sequentially.

How Does Xcel Energy Meter Pull Scheduling Work?

Xcel assigns a scheduled date after reviewing your contractor’s service request. Standard lead time in the Twin Cities metro is 1-3 weeks for a straightforward service upgrade. More complex jobs, or requests submitted during peak scheduling windows, can run up to 2-12 weeks from application to confirmed job day.

If anything changes after the request is submitted - the job date shifts, the scope expands, a different meter socket is needed - the request has to be updated. Last-minute changes can push the confirmed date further out. Lock your scope before the Xcel submission goes in, and treat that submission date as a commitment.

On job day, Xcel’s crew arrives in the morning to pull the meter. From that point forward, your home has no power until reconnect is authorized. Timing of the morning pull can vary, so your electrician should confirm the Xcel arrival window when the job is scheduled.

The Day of the Job: What to Expect Hour by Hour

Understanding the sequence helps you plan your day and set realistic expectations for when the lights come back on.

Morning - Xcel arrives and pulls the meter. The service entrance is de-energized. Power goes out at this point, and it stays out until reconnect is authorized after inspection.

During the job - installation runs 4-8 hours for a standard 200-amp service upgrade. The crew installs the new panel, replaces the meter socket if needed, installs the required outdoor emergency disconnect, and installs the whole-home surge protector. Under Minnesota’s adopted electrical code, both the outdoor emergency disconnect and the whole-home surge protector are required on any service upgrade - they are mandatory line items in the job scope, not optional additions. Any quote missing either of those components is not a complete scope.

Inspection. After installation is complete, the inspector visits and reviews the work. They are checking the new panel, the meter socket, grounding and bonding, the outdoor disconnect, and the surge protector. The inspector stamps or approves the inspection certificate on site.

After inspection - the certificate goes to Xcel. This is the gate. Xcel will not reinstall the meter until they receive the approved certificate. The inspector submits it directly in most cases, but the speed of that handoff varies by jurisdiction.

Reconnect. Here is where smart meters change the equation. Xcel’s advanced metering infrastructure enables remote reconnection in as little as 15 minutes without sending a truck. If your address does not have a smart (AMI) meter, Xcel dispatches a crew, which adds unpredictable time to the wait. Smart meter coverage across the Twin Cities metro is not uniform. Ask your electrician before the job whether your address is on the AMI system - the answer directly affects whether power is back before dinner or the next morning.

What Has to Happen for Power to Come Back On the Same Day?

Two things must align: the inspector approves and the certificate reaches Xcel, and Xcel processes the reconnect. With a smart meter and no complications, reconnect after an approved certificate can happen in under 30 minutes. Without a smart meter, a truck visit is required and timing becomes much harder to predict.

The most common reason power does not come back the same day is inspection scheduling. Inspectors work set windows. If your inspection cannot be scheduled until late afternoon and the inspector signs off at 4:30 p.m., reconnect may not happen until the following morning if a Xcel truck is needed. Your electrician should be booking the inspection appointment as early as possible - ideally before the job date is confirmed, not the morning of.

Delays can also come from incomplete Xcel documentation. This is another reason contractor experience matters: a team that has coordinated dozens of panel upgrades with Xcel knows exactly what the service request needs to include and does not generate delays from missing fields.

Minneapolis vs. Saint Paul vs. Suburbs: AHJ Differences That Matter

Where you live in the Twin Cities determines who inspects your electrical work. That AHJ determines your inspection scheduling windows, which directly affects same-day reconnect feasibility.

Minneapolis is its own Authority Having Jurisdiction for electrical inspections. The City of Minneapolis schedules and conducts its own inspections independently of the Department of Labor and Industry (DLI). Contractors coordinate directly with the city’s inspection department. Minneapolis inspection windows can be tight during busy seasons, so booking early is essential.

Saint Paul moved all electrical permit applications to the PAULIE platform as of September 9, 2026. Contractors and homeowners must register for a free account to apply and track permits and inspections. This is a very recent change - contractors who have not yet registered on PAULIE will run into a slower permit process until they do. If you are in Saint Paul, ask your electrician directly whether they are already set up on the new system before you commit to a job timeline.

Most Twin Cities suburbs - Bloomington, Brooklyn Park, Woodbury, Blaine, Maple Grove, Plymouth, and surrounding communities - use DLI inspectors. DLI scheduling windows vary by season and current workload. Your contractor will know current DLI wait times and factor them into your job day plan.

The practical upside: a contractor who works regularly across the metro is already set up in all three systems and knows how far in advance to schedule inspections in each jurisdiction. That knowledge is built into the timeline we give you before you sign anything.

Does Minnesota Have a Rebate for Panel Upgrades?

Yes. Xcel Energy offers a $1,500 rebate for qualifying residential panel upgrades. To qualify: you must be an Xcel customer, upgrade to a higher amperage, use a licensed electrician, and be in a 1-4 unit residential property. After the job, you submit your invoice and permit approval to Xcel. The rebate arrives 6-8 weeks after submission.

For a full overview of what is available through Xcel’s programs, see our post on Xcel Energy electrical rebates in Minnesota.

On a $7,700-$9,500 installed job, the $1,500 rebate brings your net cost down by 16-19 percent. That is real money. Submit the paperwork promptly after the job closes - do not wait.

One thing worth knowing: there is no active Minnesota state grant program for panel upgrades as of September 2026. The MN Commerce “Save Energy Minnesota” program is pending federal approval with no confirmed launch date. Do not plan your project budget around a state grant that is not yet available.

What Does a Panel Upgrade Cost in the Twin Cities?

A 100-amp to 200-amp service upgrade, fully installed, runs $7,700-$9,500 in the Twin Cities metro. That price covers the new panel, meter socket, outdoor emergency disconnect, whole-home surge protector, grounding and bonding work, Xcel coordination, and the permit.

Those are not line items you can remove to lower the price. The outdoor emergency disconnect and the surge protector are required by Minnesota electrical code on any service upgrade. A quote that does not include both of those components is not a complete scope - it will either get flagged at inspection or show up as a cost adder at the end.

After the Xcel $1,500 rebate, your net cost is closer to $6,200-$8,000. Financing is available for panel upgrades. Ask when you call or book online.

What Does the 2026 NEC Change Mean for Your Job?

All permits filed on or after August 17, 2026 fall under the 2026 National Electrical Code. Prior permits follow the 2023 NEC. Minnesota adopted the NEC as state law under Chapter 1315 of the MN State Building Code, and that adoption date is a hard cutoff.

If you received a quote before mid-August 2026 and are signing a contract today, your job will be permitted under a different code edition than the one your quote was based on. That can affect specific requirements in the scope. A competent contractor will flag any changes the new code requires before you sign. Ask directly: has this quote been reviewed against the 2026 NEC?

For most standard 200-amp panel upgrades, the change will not dramatically alter the scope - the outdoor disconnect and surge protector were already required under 2023. However, in grounding electrode system specifics and AFCI expansion requirements, there can be differences that show up at inspection if the scope was not updated.

Can You Schedule a Panel Upgrade in Winter?

Yes, panel upgrades happen year-round in Minnesota. The key is planning around the outage window and the cold.

You will be without power for 4-8 hours on a standard 200-amp upgrade. In January, that means no electric heat for the duration of the job. Plan temporary heat for the house before the job date - a propane heater in a main living area covers most situations. Your electrician should talk through this with you as part of the job planning.

One clarification worth making: Xcel’s Cold Weather Rule applies from October 1 through April 30 and restricts utility-initiated disconnects for customers using electricity as their primary heat source. A contractor-planned meter pull for a panel upgrade is not a utility-initiated disconnect. The Cold Weather Rule does not prevent you from scheduling a panel upgrade in February. It applies when Xcel disconnects for non-payment. The distinction is clear, and the two are not the same situation.

Homeowner Prep Checklist for Your Outage Window

Do these before the crew arrives:

  • Food and refrigerator: Move anything temperature-sensitive to a cooler the morning of the job. A 4-8 hour outage will not ruin a sealed refrigerator, but do not push it.
  • Work and school: Flag the outage day in advance. If you work from home, plan to work offsite or have hotspot data ready.
  • Medical equipment: If anyone in the household uses powered medical equipment, coordinate with your care team for the outage window before the job date is confirmed.
  • Heat in winter: Confirm your temporary heat plan before the job is scheduled, not the day before.
  • Clocks and devices: Every clock on a microwave, stove, and appliance will need resetting after power returns. Minor, but worth knowing.
  • Pets: Keep them secured. A crew working with the panel open and exterior doors propped is not a safe environment for a pet that bolts.
  • Neighbors: If you share a driveway or the work affects your property line, let neighbors know the job is happening.

Book Your Panel Upgrade with Northern Mister Sparky

A panel upgrade in the Twin Cities involves coordinating your permit, Xcel Energy’s meter pull, your local AHJ’s inspection schedule, and the reconnect - all within a single workday. When those pieces are aligned by an experienced team, power is back on before dinner. When they are not, you are waiting another day.

As a locally owned and operated Twin Cities electrician and America’s On-Time Electrician(R), we handle Xcel coordination, permit filing, and inspection scheduling on every panel job. We are set up on Saint Paul’s PAULIE platform, we know Minneapolis’s inspection calendar, and we work with DLI inspectors across the suburbs daily. You do not have to manage any of that coordination yourself.

If your home is showing signs you need an electrical panel upgrade, do not wait for a tripped breaker or a home inspection to make the call. Call us at 763-200-5956 or book online - we will walk you through the full timeline and what to expect from day one. Our work is backed by the UWIN(R) 100% satisfaction guarantee. No malarky.

Frequently Asked Questions

How long does an Xcel Energy meter pull take for a panel upgrade? +
The meter pull itself takes 30-60 minutes. Total power outage for a standard 200-amp upgrade runs 4-8 hours, covering installation and inspection. Xcel reconnects the meter only after your inspector approves the work and submits the inspection certificate.
Does Xcel Energy coordinate the meter pull, or does my electrician? +
Your licensed electrician submits the disconnect and reconnect request to Xcel via the online portal at my.xcelenergy.com/BuildingRemodeling or by email to bclco@xcelenergy.com. Homeowners do not contact Xcel directly for a panel upgrade.
How much is the Xcel Energy panel upgrade rebate in Minnesota? +
Xcel Energy offers a $1,500 rebate for qualifying panel upgrades. To qualify, you must be an Xcel customer, upgrade to a higher amperage, use a licensed electrician, and submit your invoice plus permit approval. The rebate is paid 6-8 weeks after submission.
